• Wapping 2

    Wapping 2

Wapping 2

The Property team completed the purchase in July 2020. The existing buildings are immediately adjacent to the existing Big Yellow Wapping store and previously operated as a Volkswagen Car dealership with servicing. There are now a number of tenants in occupation on short term leases and uses include an eco bike retailer, offices and storage.

The site of the new store is located on The Highway approximately 0.5km to the east of the Tower of London. This major throughfare can trace its history back to Roman, Anglo-Saxon and Medieval times. A Scheduled Roman bath house lies to the east of Wapping Lane at 172 – 179 The Highway. Understandably, an archaeological dig will be undertaken prior to construction activities starting on site. In the 19th Century, the current plot was largely occupied by residential properties which underwent some changes caused by WW2 bombing. There were no major changes until the Garage was built between 1985 and 1989. Close by are Tobacco Dock and London Dock, which is currently  undergoing redevelopment as residential apartments.

The new store proposal is for a self storage facility with flexi offices 130,000net sq ft MLA at basement and ground levels plus seven floors of storage.

The redevelopment proposals were submitted to the local planning authority in November 2021. We are targeting a BREEAM accreditation of Excellent.

Demolition and site clearance works are due to start once planning approval is obtained for the redevelopment.

Planning approval has been obtained, we are now forging ahead with the redevelopment.

Nigel Hartley, Big Yellow Construction Director

  • Architect:  Mountford Pigott
  • Engineer:  Campbell Reith
  • Project Manager & QS: CSA
  • Principle Designer (Health & Safety):  RGP Development Services
    M&E Services:  Silcock Dawson

Target Programme
Shell Construction: tba
Fit out due: tba
Store Opening Date: December 2026

  •

2020

Wapping 2 existing site.JPEG

Summer

Existing site

2020

July

The property team complete the purchase

2021

November

Redevelopment proposals submitted

2023

24th August

Planning consent received

2024

15th January

Soft strip demolition started

2024

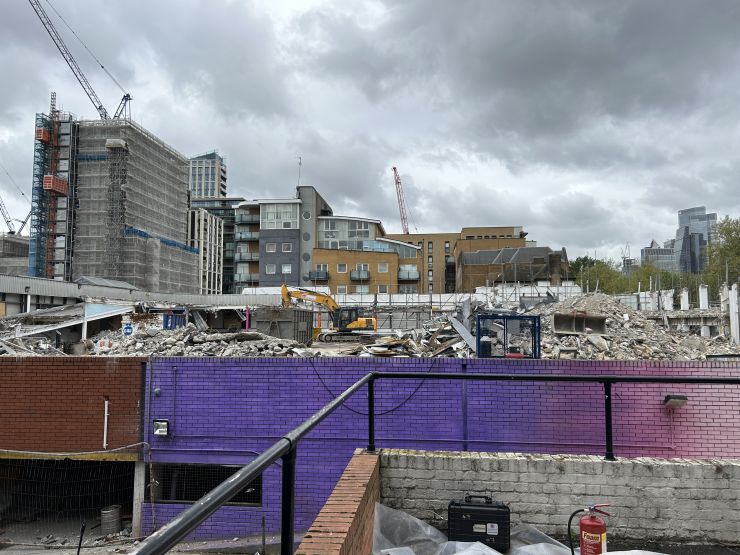

Demolition continues - Wapping 2.JPG

16th April

Demolition continues

2024

Wapping2 Demolition of upper floors nearly complete.jpg

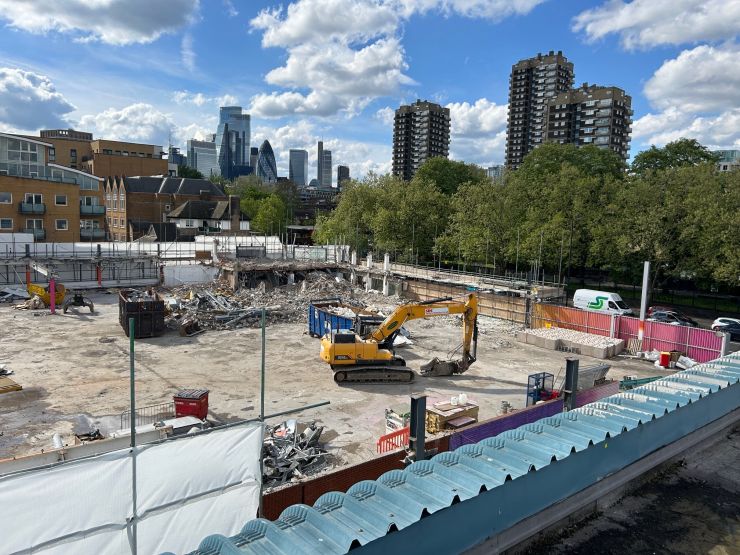

May

Demolition of the upper floors nearing completion to the ground floor podium level.

2024

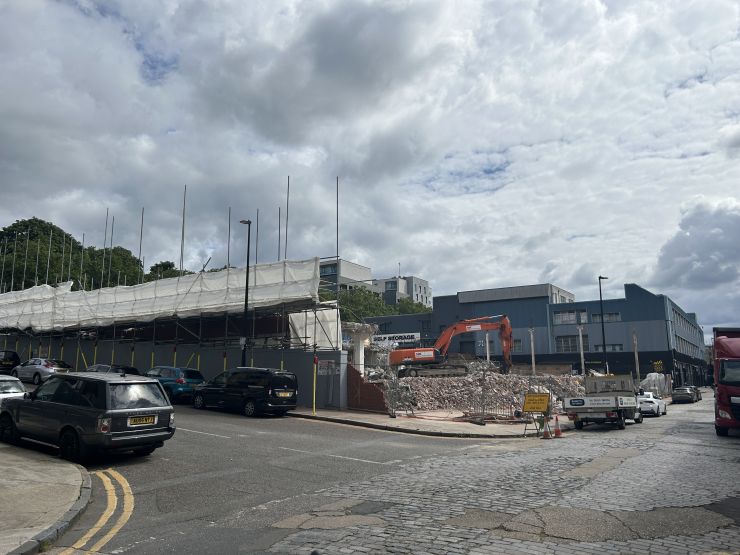

Wapping2 Demolition of building complete.jpg

June

Demolition of the building now complete to ground level.

2024

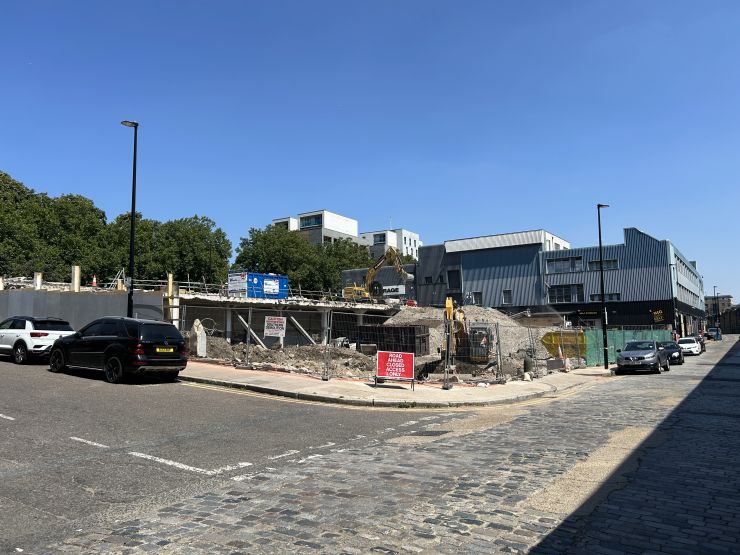

Wapping2 Demolition nearing completion.jpg

July

Demolition works are nearing completion with ground obstructions being removed ready for crushing.

2024

Wapping2 Archaeology excavation.jpg

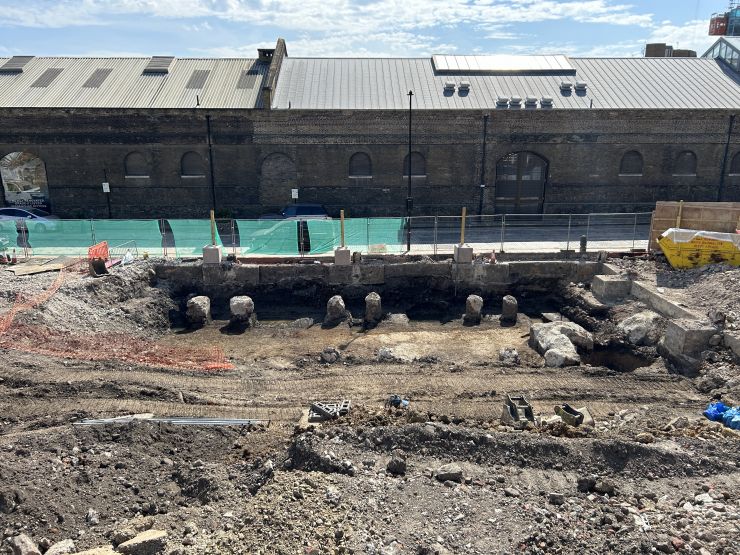

August

Archaeology excavation works ongoing to the lower section of the site.

2024

Wapping2 Piling Mat complete.JPG

September

Piling mat complete to the upper level ready for piling works to commence in October.

2024

Wapping2 Civilisation nearly complete.JPG

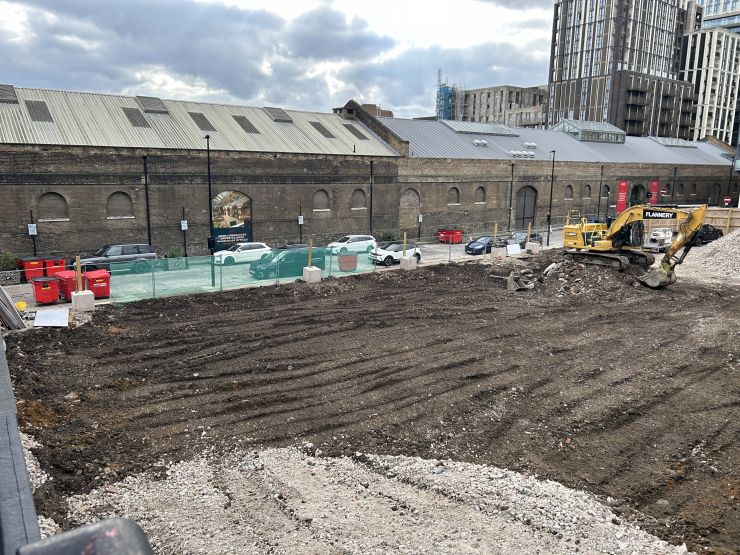

End of September

Final civilisation of the site nearing completion, ready for practical completion of the demolition works this month.

2024

Wapping2 build phase commences.jpg

October

Galliford Try commence the build phase with pilling works to the upper level of the site.

2025

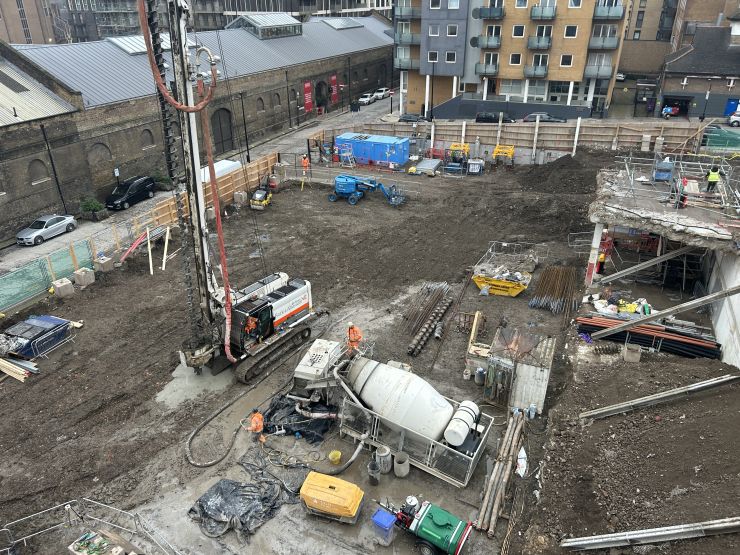

Wapping2 piling works commenced.JPG

February

Piling works have commenced to the southern section of the site following the archaeology investigation works which completed in August 2024.

2025

Wapping2 Archaeology works underway.JPG

February

Archaeology works are underway to the Northern part of the site adjacent following the completion of the piling and capping beam works.

2025

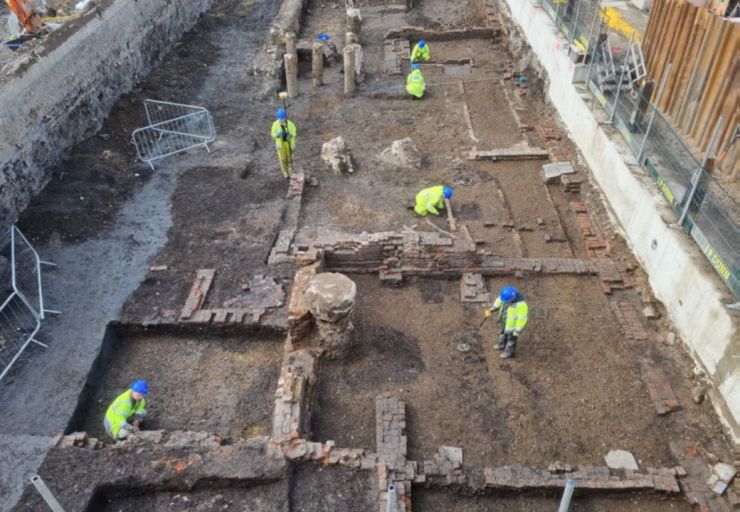

Wapping2 northern area as recording progresses 25-02.jpgWapping2 Archaeology Overview 25-02-25 .jpg

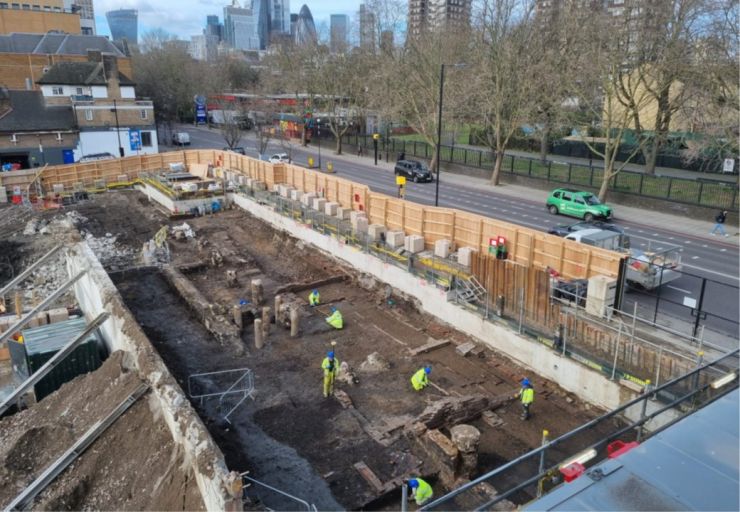

25th February

As the archaeology works progress, the remains found comprise the buildings which once fronted north to The Highway.

2025

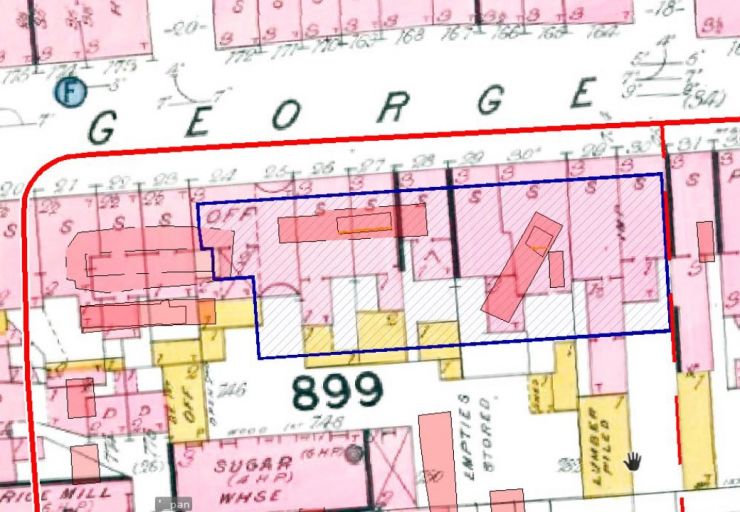

Wapping2 map.jpg

25th February

The map above shows the excavation area superimposed to the 1887 Goad Map, which shows the outlines of the buildings which are being found in a fragmented state.

These remains, however, date from earlier than the late 19th century, most likely in the late 18th or early 19th centuries.

2025

Wapping2 Conch Shell.jpg

Wapping2 Presumed 19th century harp pin.jpg

February

This archaeology excavation process has revealed some interesting artefacts which illustrate the life and trade of the inhabitants to the buildings through the 19th / 20th centuries.
Above you can see a conch shell and a presumed 19th century harp pin.

2025

Wapping2 ground works continue.jpg

March

Ground works continue to the southern section of the site to install the reinforced pile cap cages and concrete.

2025

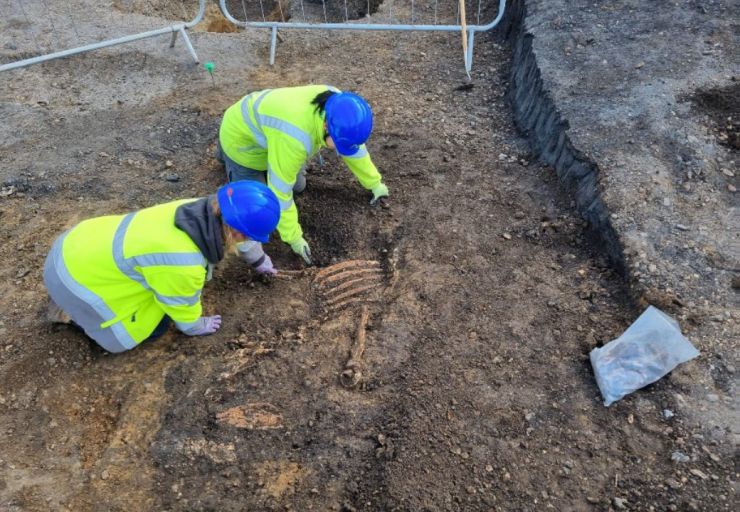

Wapping2 post-medieval horse burial.jpg

March

During the excavation of a large post-medieval pit containing what appears to be a horse burial.

2025

Wapping2 parallel Roman ditches.jpg

March

The above photos shows the Roman archaeology which is dominated by a large E-W aligned ditch which runs along the northern boundary of the site. We can now see that this feature was around 1.2m deep, and was accompanied by a smaller, shallower ditch running parallel on its southern side. Such double-ditch arrangements are not uncommon in the archaeological record.

2025

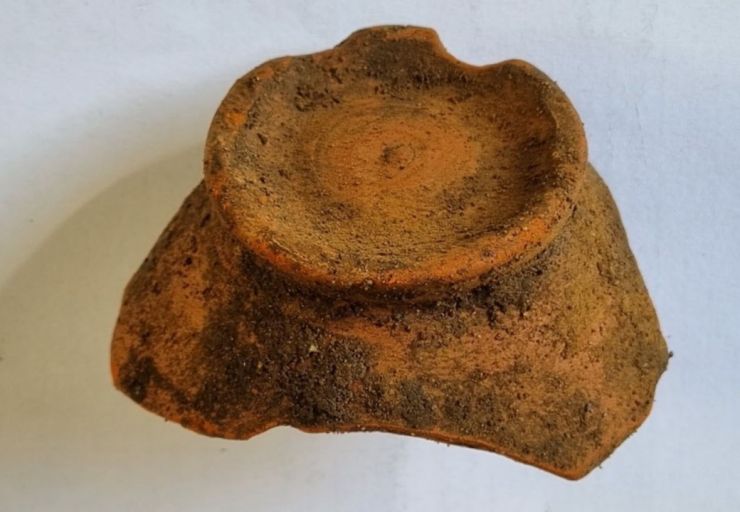

Wapping2 Examples of diagnostic Roman pottery 2.jpgWapping2 Example of diagnostic Roman pottery.jpg

March

Examples of diagnostic Roman pottery

2025

Wapping2 Groundworks commenced.jpg

May

Now that the Archaeological works have completed, the remaining ground works have commenced to the northern section of the site, whilst superstructure works to form the ground floor progress to the southern part of the site.

2025

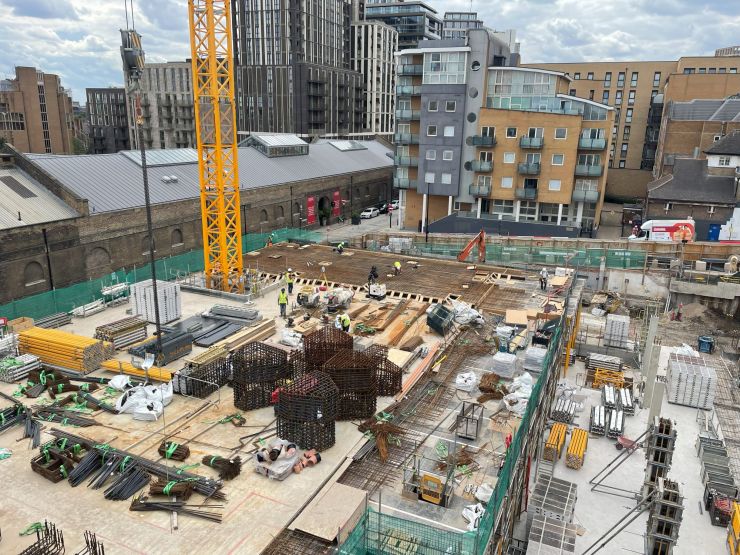

Wapping service yard slab.jpg

July

The service yard slab has now been cast with works ongoing to form the columns at the lower ground level so slab works can continue. The 1st of 2 tower cranes has now been erected.

2025

Wapping 2nd tower crane installed.jpg

August

The 2nd tower crane has now been installed and the 1st Phase of the steelwork has commenced.

Traffic on The Highway is busy as usual at this great location!

2025

Wapping phase 1 steel erection.jpg

September

Phase 1 steel erection continues with the installation of the double height trusses over the service yard now progressing.

2025

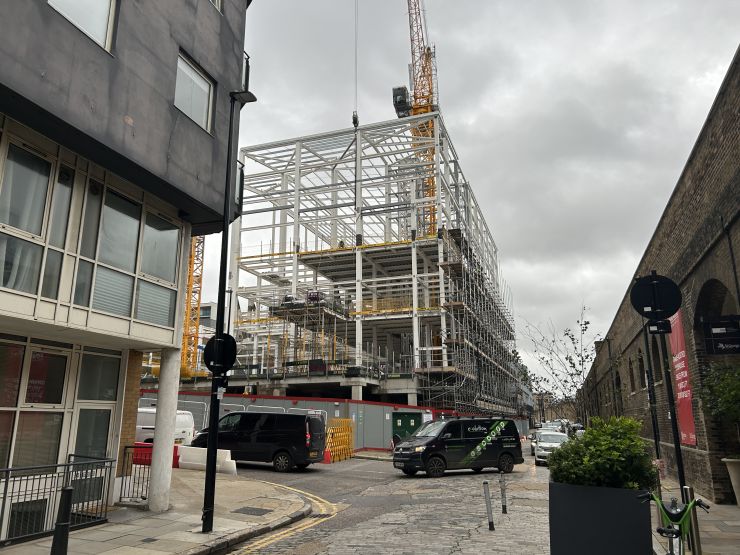

Wapping phase 1 steel erection complete.jpg

November

Now that Phase 1 of the steel erection is complete, scaffolding to the rear is ongoing in readiness for the external façade works to commence later this month.

2025

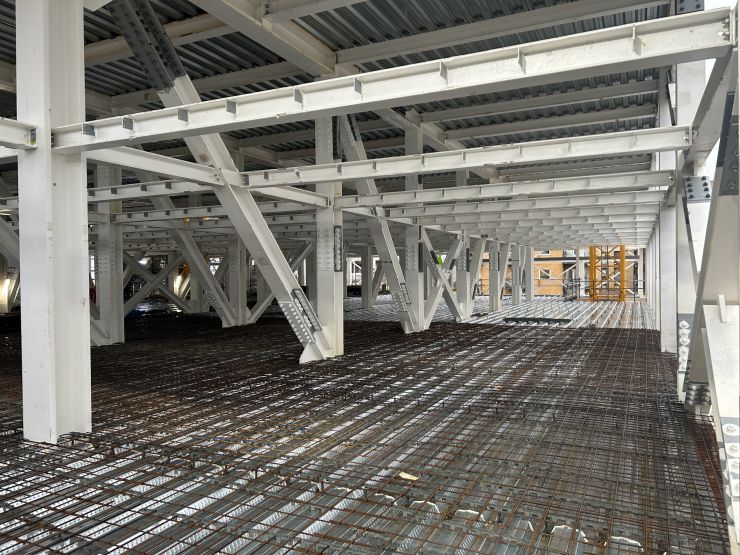

Wapping 2 conrete 2nd & 4th floors.jpgDecember

Works to form the concrete 2nd and 4th floors are progressing well with the mesh reinforcement works progressing ready for the concrete pour next week.

The double height trusses and diagonal bracing hold up the upper floors to allow for a service yard free from structural columns.

2026

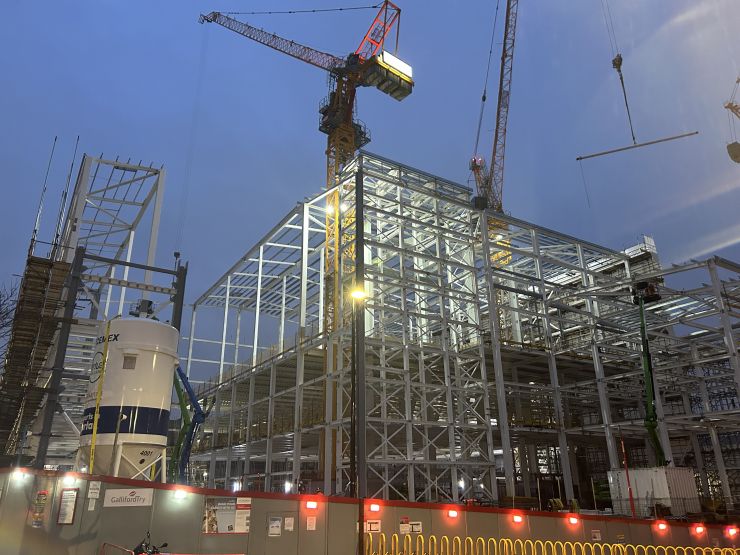

Wapping 2 phase 3 & 4 steelworks.jpgJanuary

The steelwork erection continues nearing completion on Phase 3 and Phase 4 has now commenced concurrently.

2026

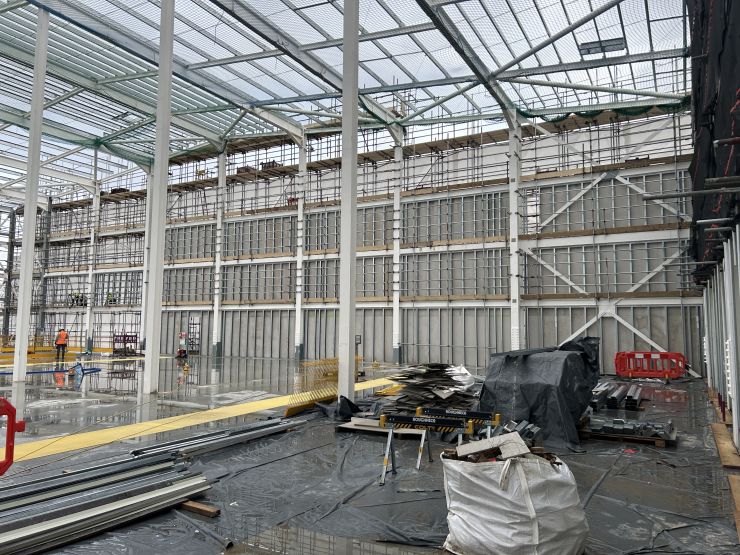

Wapping 2 external walls progressing.jpgFebruary

Now that the upper phases of steel erection are complete, external wall works are progressing on programme.

The installation of the safety netting is ongoing ready for the roof works to commence next week.

2026

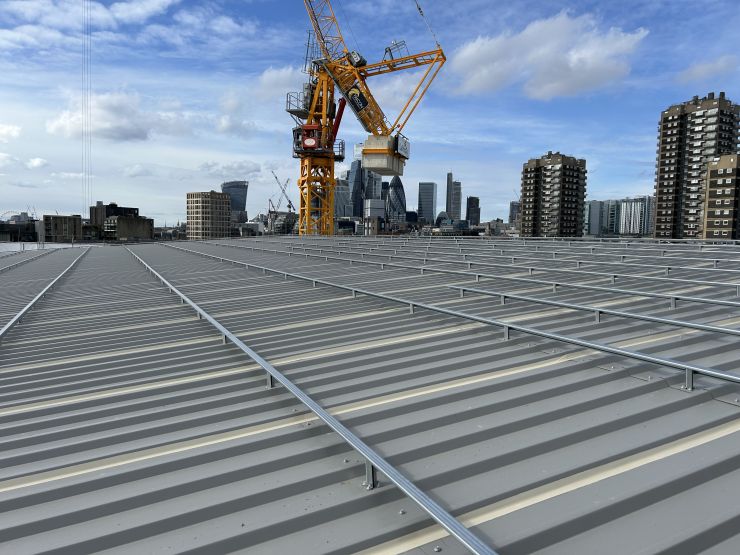

Wapping 2 inner lining nearly complete.jpgMarch

The inner lining sheets are nearing completion to the upper roof which provides amazing views across central London and beyond.

2026

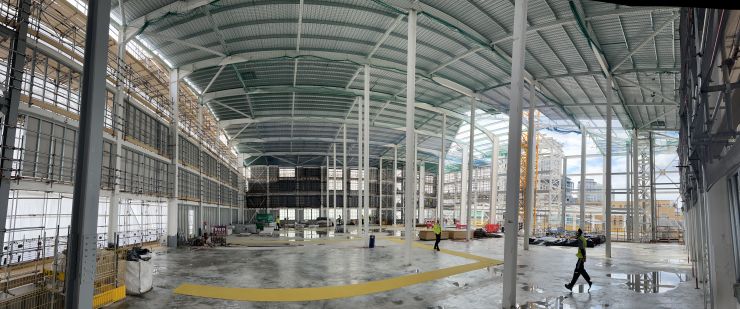

Wapping 2 croncrete 4th floor complate.jpgMarch

The concrete floor is now fully complete to the 4th floor level. Once works are nearing the water tight stage, a 3 tier mezzanine will be installed to form the 5th, 6th and 7th floors.

2026

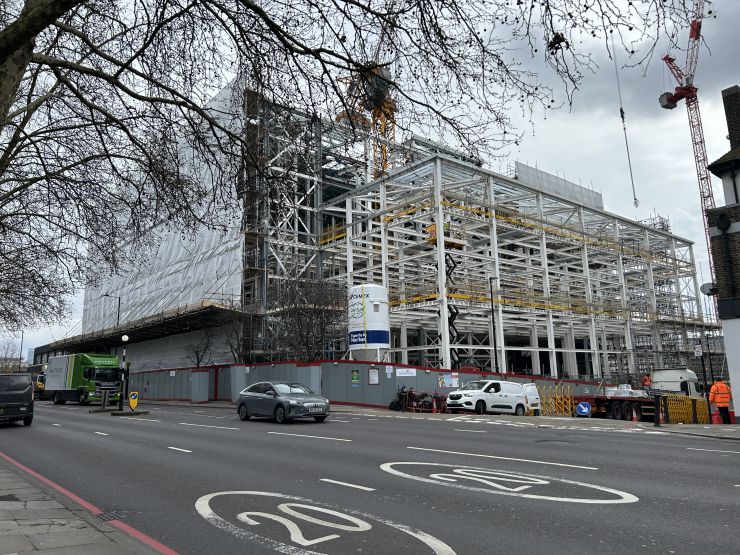

Wapping 2 steal frame complete.jpgMarch

The steel frame is now complete which is a fantastic milestone for the project. 2,500 tonnes of steel and many hours of labour….

Store Opening

Dec 2026
