The Property team first considered the site’s potential in this affluent historic market town in Summer 2018. Big Yellow’s initial bid was unsuccessful however post pandemic, the site was remarketed and eventually acquired in January 2021. The existing buildings are operated as a Majestic Wine warehouse with the adjacent Office Outlet recently vacated.
The site of the new store is located on East Street with the High Street less than 500m away. In the mid 19th century the site was partially occupied by open land and trees with a row of residential properties added around 1896. The current warehouse building with car parking was constructed in 1983 and remained largely unchanged until the present day. Adjacent the property is a Gas Works, decommissioned in 2013 with student residential properties developed adjacent by 2020.
The new store proposal is for a self storage facility with flexi offices totalling 58,000 net sq ft MLA at ground floor level plus four floors of storage.
The redevelopment proposals were submitted to the local planning authority in September 2021. We are targeting a BREEAM accreditation of Very Good.
Demolition and site clearance works are due to start once planning approval is obtained for the redevelopment.
Nigel Hartley, Big Yellow Construction Director
Architect: Cornish Architects
Engineer: Campbell Reith
Project Manager & QS: Colliers
Principle Designer (Health & Safety): RGP Development Services
Target Programme Shell Construction: Commences February 2025 Store Opening Date: May 2026
2022
Spring / Summer
Site clearance and enabling works
2023
Summer
Shell Construction provisional start date
2024
Spring
Big Yellow Fit Out due to commence
2024
September

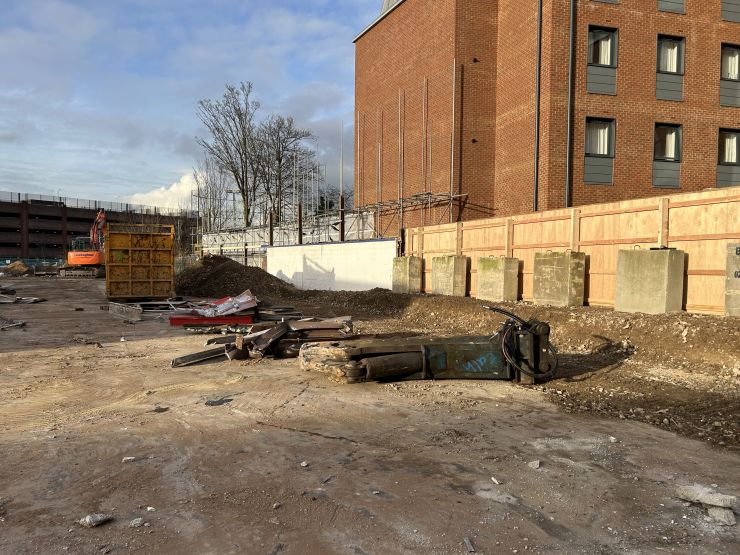

Demolition works commence and are expected to be completed in January 2025.
2024
December

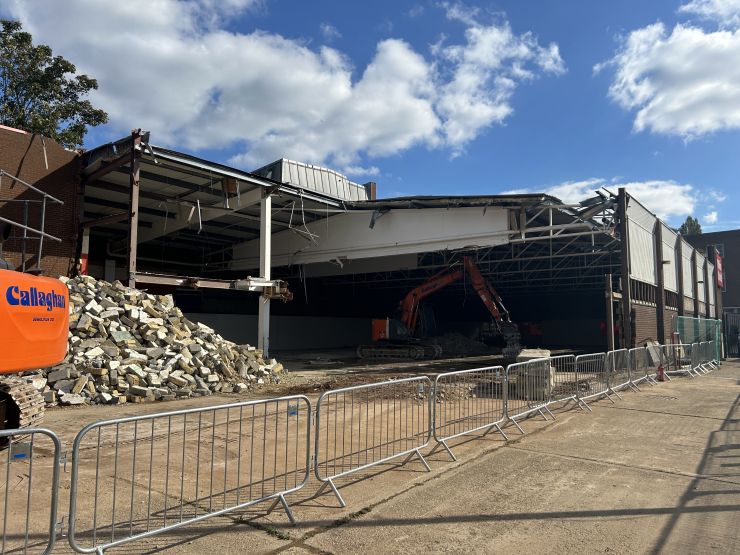

Demolition works of the building along the northern boundary near completion. Works were carried out in agreement with the neighbours to ensure minimal disruption.
2024
December

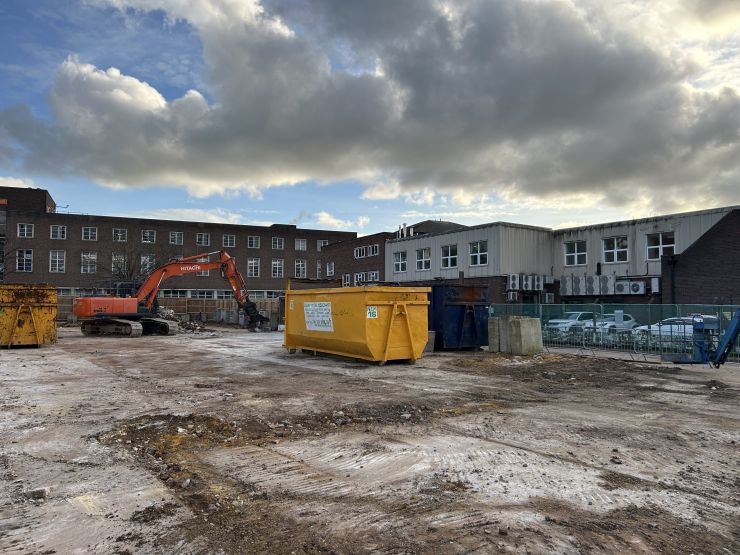

Demolition of the main building, now complete ready for the next stage to remove the slab and foundations and commence crushing.
2025
February

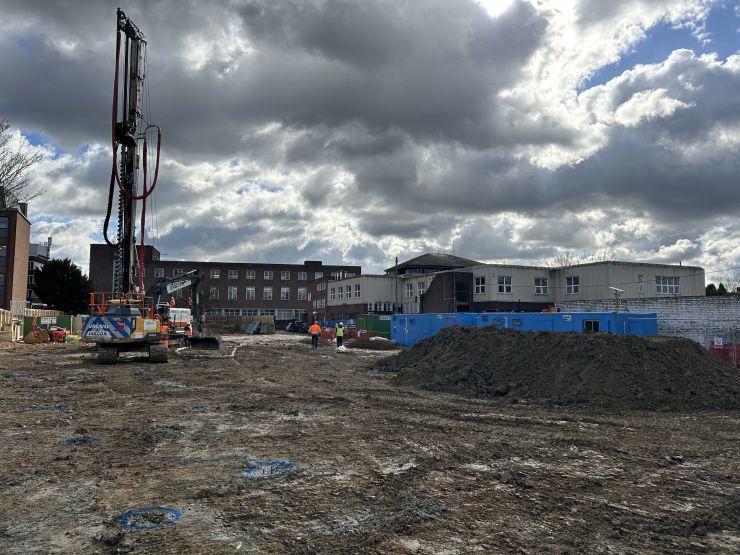

The main works have now commenced, starting with the installation of the piles.
2025
May

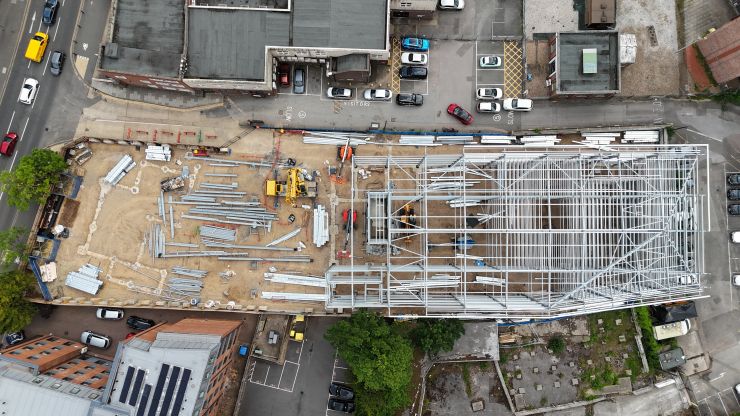

Works to erect the steel frame are now well underway as you can see from this aerial shot.
2025
June

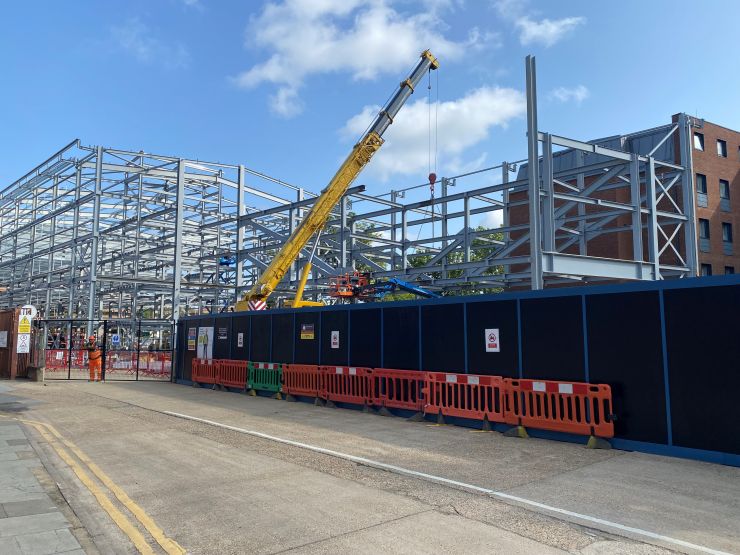

Works to erect the steel frame are progressing well, with the frame due to be completed in the next 2 week.
2025
July

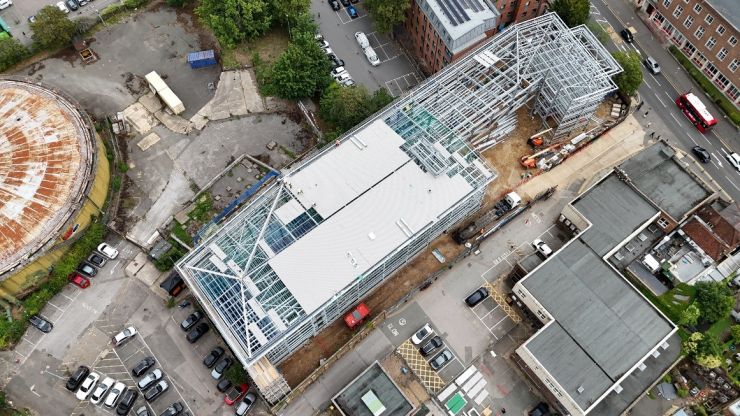

The steel frame is now complete other than a small section to allow the roofing materials to be craned onto the roof.
2025
August

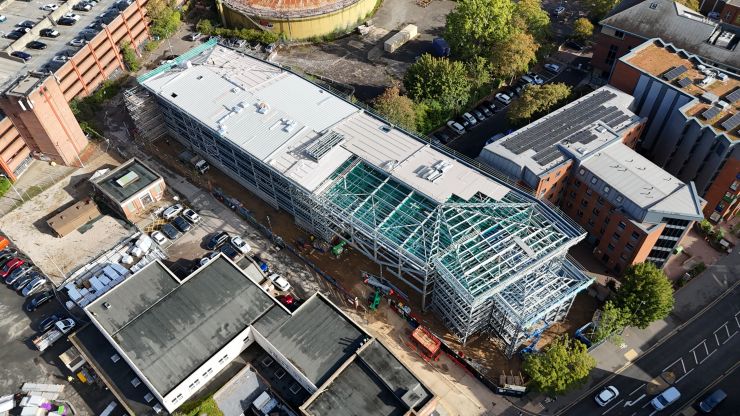

Roof cladding works are progressing well, and the infill section of steel frame is complete.
